How Long Does It Take to Produce a Bulk Order of Underwear?

18 min read

How Long Does It Take to Produce a Bulk Order of Underwear?

You placed an order. Now you’re watching the calendar. Your launch date is locked, your ads are booked, and you still don’t know when your underwear will actually ship.

A typical bulk underwear order takes 30–45 days after all order details and pre-production approvals are confirmed. This does not include sampling time or international shipping. The actual clock starts only when fabrics, trims, size ratios, and pre-production samples are all signed off.

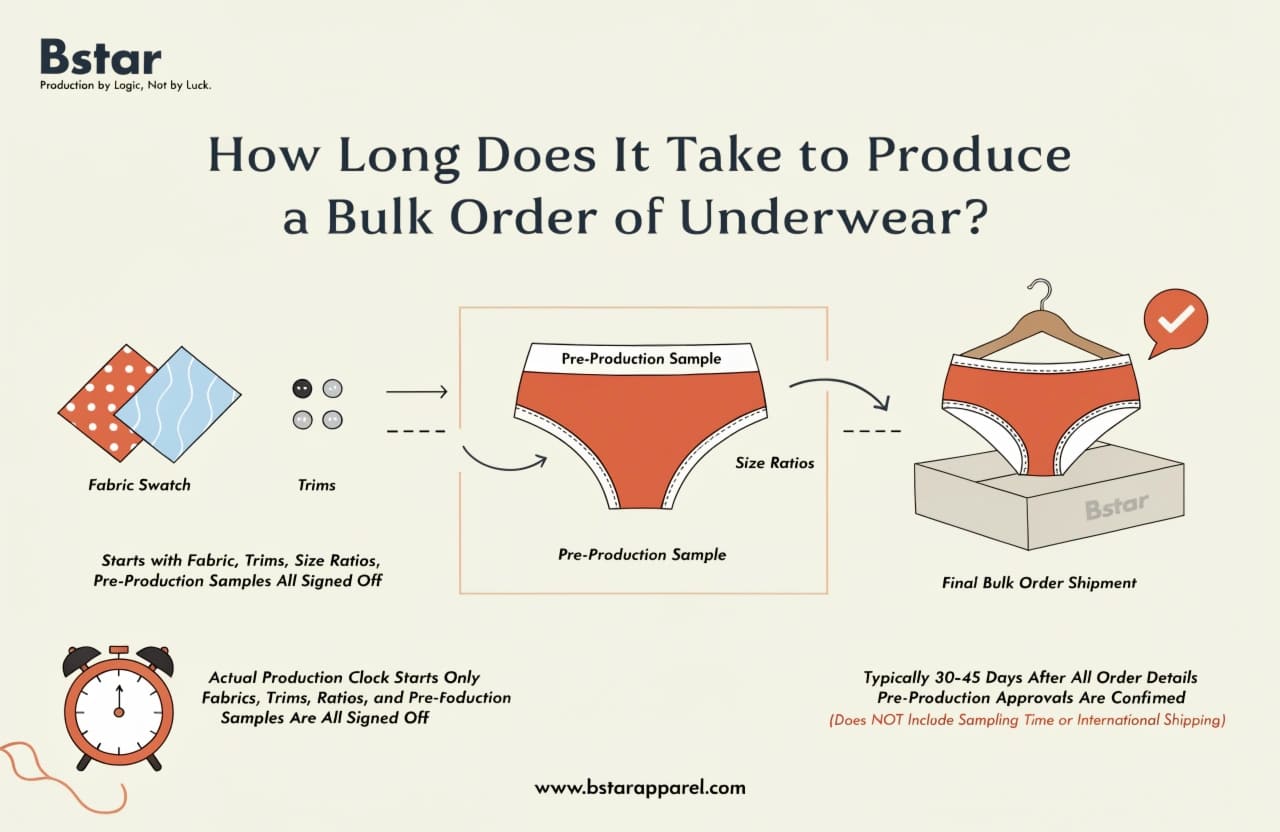

bulk underwear production timeline from sampling to shipment

Most delays we see don’t happen on the sewing line. They happen before production even starts. Understanding where the time actually goes is the first step to protecting your launch date.


What Are the Key Production Stages from Sampling to Shipment?

Many buyers think about production time as sewing time. It isn’t. There are several stages before a single stitch is made in bulk.

The full process from order confirmation to cargo-ready typically moves through five stages: pre-production sample approval, fabric and trim sourcing, production line scheduling, bulk sewing and finishing, and final quality inspection. Each stage has its own timeline and its own risks.

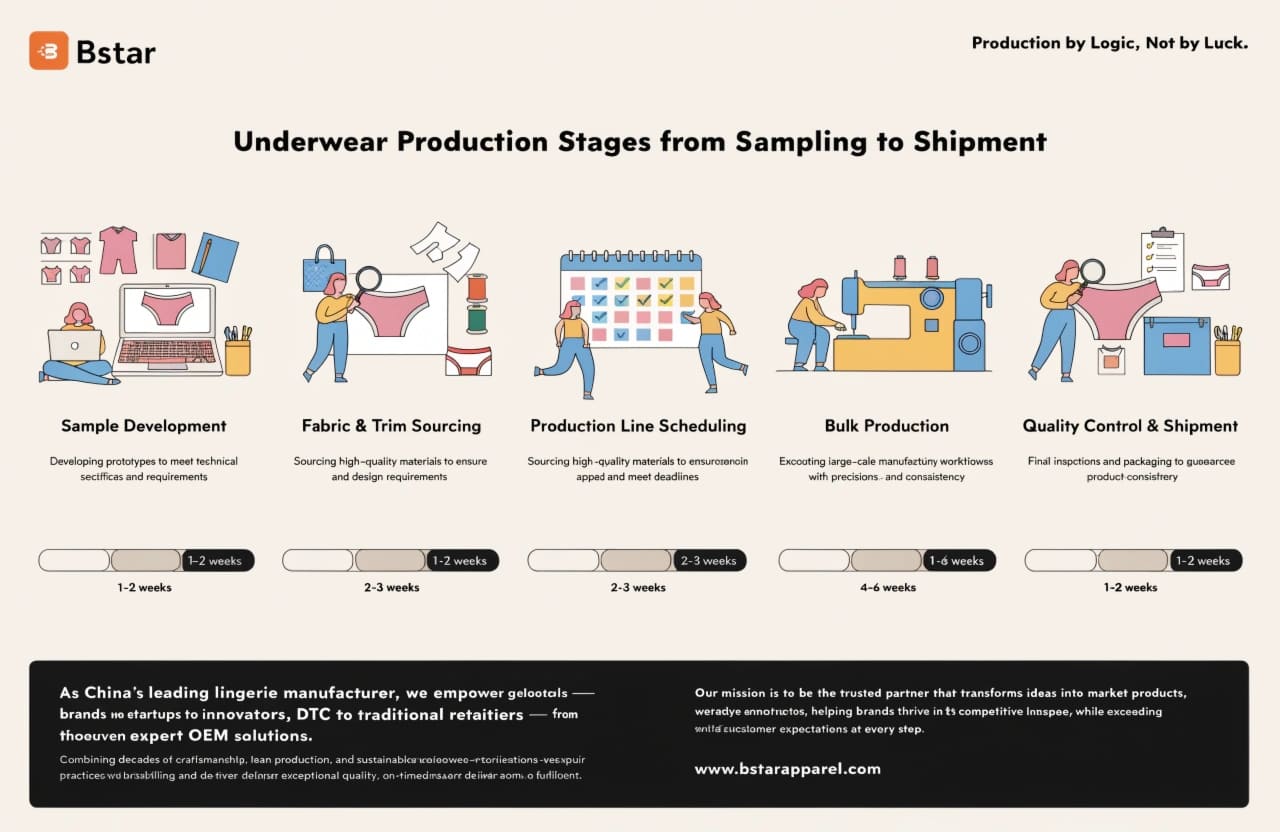

underwear production stages breakdown chart

Breaking Down Each Stage

Here is how each stage typically looks in a real underwear bulk order:

Stage Typical Duration What Can Slow It Down
Pre-production sample approval 5–10 days Revision requests, slow buyer feedback
Fabric & trim sourcing 7–15 days Custom dye lots, elastic lead times
Line scheduling 3–7 days Factory capacity conflicts
Bulk sewing & finishing 10–20 days Size ratio complexity, style count
QC inspection & cargo-ready 3–5 days Rework, re-inspection

The number that surprises most buyers is the pre-production stage. We’ve had orders where the buyer took 10 days to approve a sample that needed no changes. That 10 days came directly out of their launch window.

The stage people underestimate most is fabric and trim sourcing. Underwear is not a simple garment. It uses specific performance fabrics, narrow elastics, hook-and-eye hardware, moisture-wicking liners, and branded labels1. If any of these are custom or not in stock, the clock is running before a single sewing machine is turned on.

The sewing and finishing stage is actually the most predictable part. With our current daily capacity, bulk runs move efficiently once the line is loaded. The chaos lives upstream.


How Do MOQ, Fabric Sourcing, and Design Complexity Impact Delivery?

You might expect a larger order to take longer. That’s not always true. Sometimes a small order with complex design details takes far longer than a large order with simple, repeat styles.

Lead time in underwear production is shaped by three main variables: minimum order quantities and how they affect material commitments, fabric and trim sourcing complexity, and the number of styles, colors, and size ratios in the order. These factors compound each other.

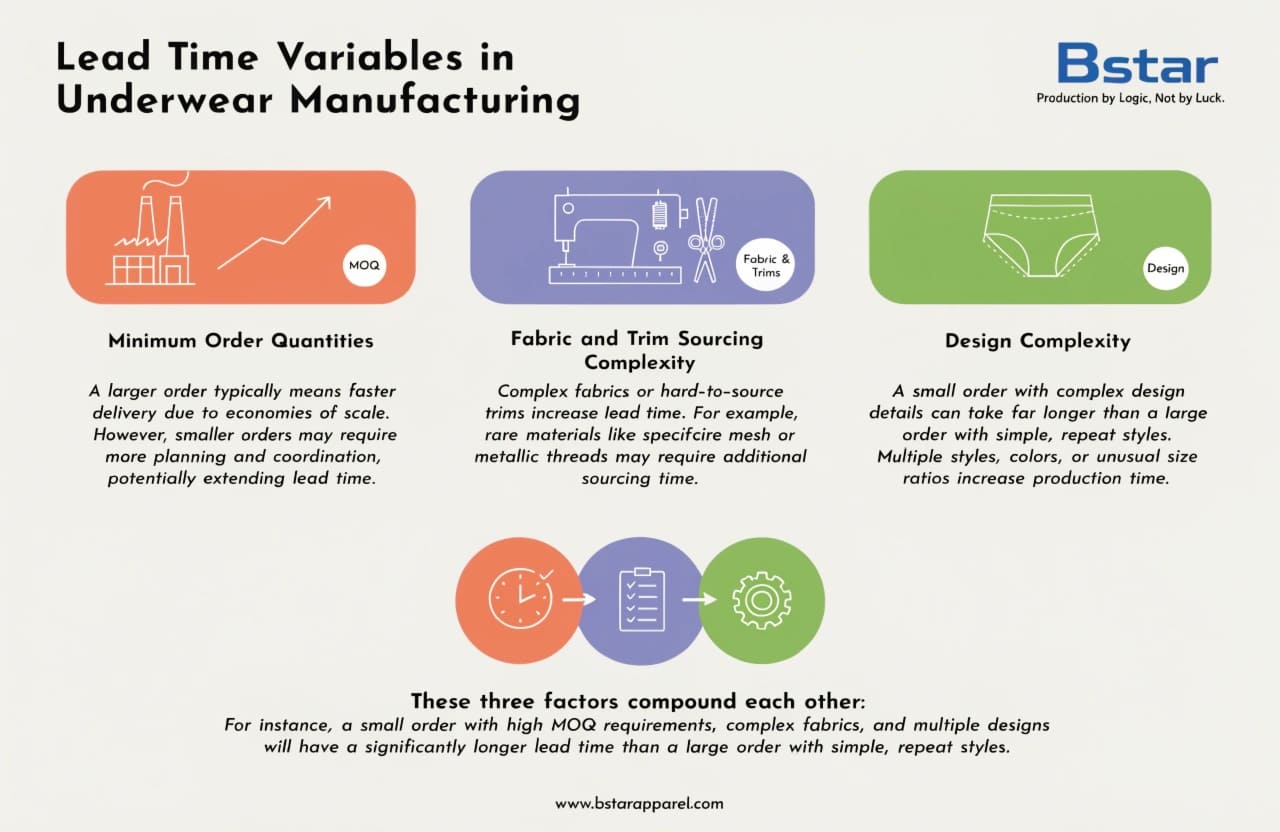

factors affecting underwear order lead time

How Each Variable Affects Your Timeline

MOQ and material commitments work together. If your order quantity is below the minimum for a specific fabric or custom elastic, the mill may not start weaving or dyeing until orders from other buyers fill the run2. Your production start date depends on someone else’s order. This happens more than buyers expect.

Fabric sourcing is where we see the most variance. Standard fabrics from stock move fast. Custom colors, sustainable certified fabrics like GOTS or GRS materials, or performance blends with specific certifications can add 10–20 days to sourcing alone3. We always recommend buyers confirm fabric options early, not after styles are approved.

Design complexity affects both pre-production approval time and bulk production speed. A brief with three colors, two size ratios, and one fabric is straightforward. An order with six colorways, a wide size range from XS to 3XL, custom packaging, hang tags, woven labels, and three different fabrics is not4. Each variable adds decision points. Each decision point is a potential delay if the buyer isn’t responsive.

Here is a simple way to think about it:

Order Type Estimated Lead Time (Post-Confirmation)
Simple reorder, same materials 25–35 days
New style, stock fabrics 35–45 days
New style, custom fabrics or trims 45–60+ days
Multiple styles, custom everything 60+ days, plan earlier

What Can You Actually Do to Speed Up a Bulk Order?

Buyers often ask us: can you go faster? The honest answer is: sometimes yes, but the speed is usually in your hands, not ours.

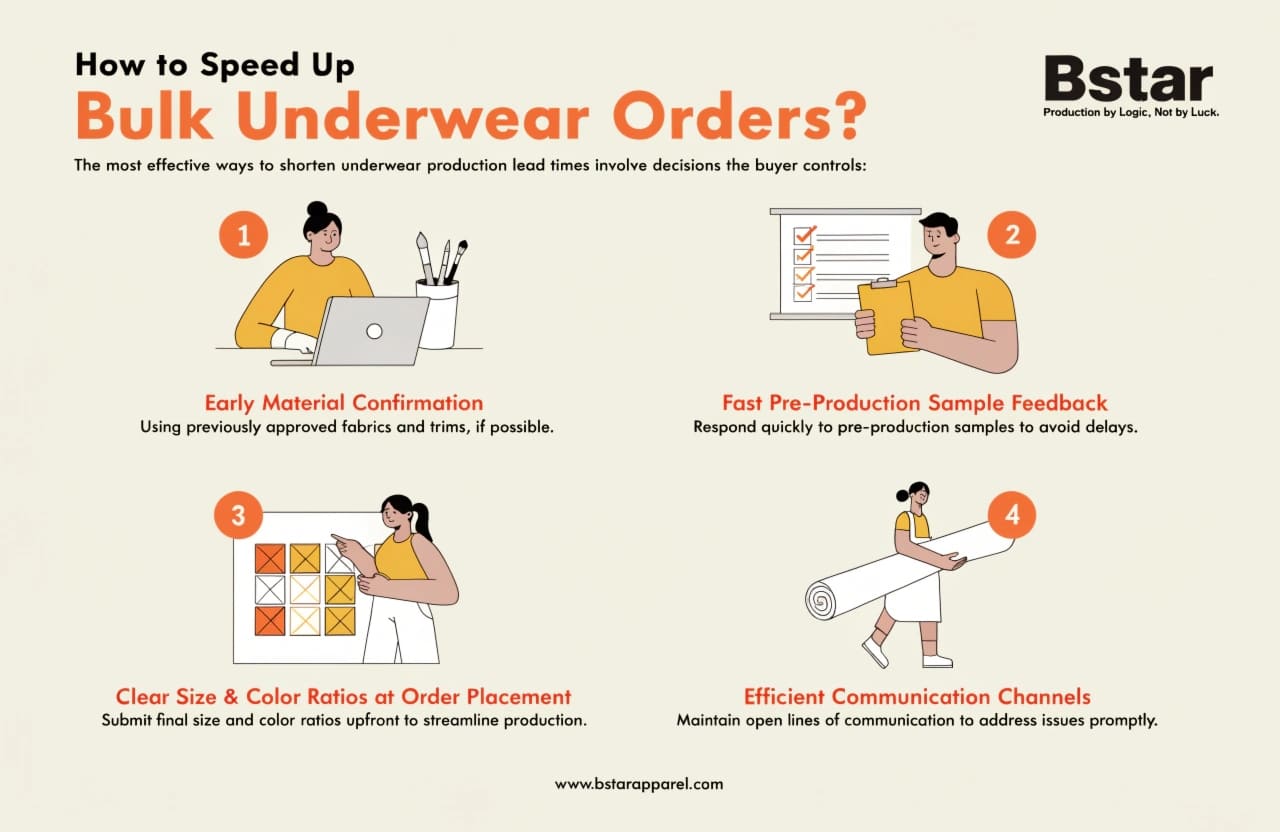

The most effective ways to shorten underwear production lead times involve decisions the buyer controls: early material confirmation, fast pre-production sample feedback, clear size and color ratios submitted at order placement, and using previously approved fabrics and trims where possible.

strategies to speed up bulk underwear orders

What Speeds Things Up on the Buyer Side

The biggest time-saver we’ve seen is buyers who come to us with a complete brief. That means:

  • Fabric type and color confirmed
  • Size ratio and total quantity confirmed
  • Packaging, labels, and hang tag artwork ready
  • A clear deadline with context (launch date, not just "ASAP")

When a buyer submits all of this at once, we can overlap some sourcing and sampling stages. When a buyer submits pieces slowly over two weeks, those two weeks are lost before production even begins.

Just-in-time scheduling is a strategy some of our DTC clients use for replenishment orders. Once a style is fully approved and materials are pre-confirmed, we can hold production slots and move faster on repeat runs. This works well for core products that sell year-round5. It doesn’t work well for new launches where approvals are still open.

One thing we never recommend: compressing QC inspection time to hit a deadline. We’ve seen brands push for early shipment and skip thorough inspection. The result is quality issues discovered after the product is already in customers’ hands6. That cost is always higher than a delayed launch.

Action Time Saved
Submit complete brief at order placement Up to 7 days
Use previously approved fabrics Up to 15 days
Fast pre-production sample approval (within 48 hrs) Up to 5 days
Pre-confirm packaging and labels before sampling ends Up to 5 days

How Does Shipping and Customs Add to Your Total Timeline?

Production being "cargo-ready" is not the same as product being "in your warehouse." This is a mistake we see DTC brands make when planning launch dates.

International shipping from China to Europe or North America typically adds 25–40 days by sea freight or 5–10 days by air freight7. Customs clearance can add 3–10 additional days depending on the destination country, the shipment documentation, and whether your products require any specific certifications or labeling compliance8.

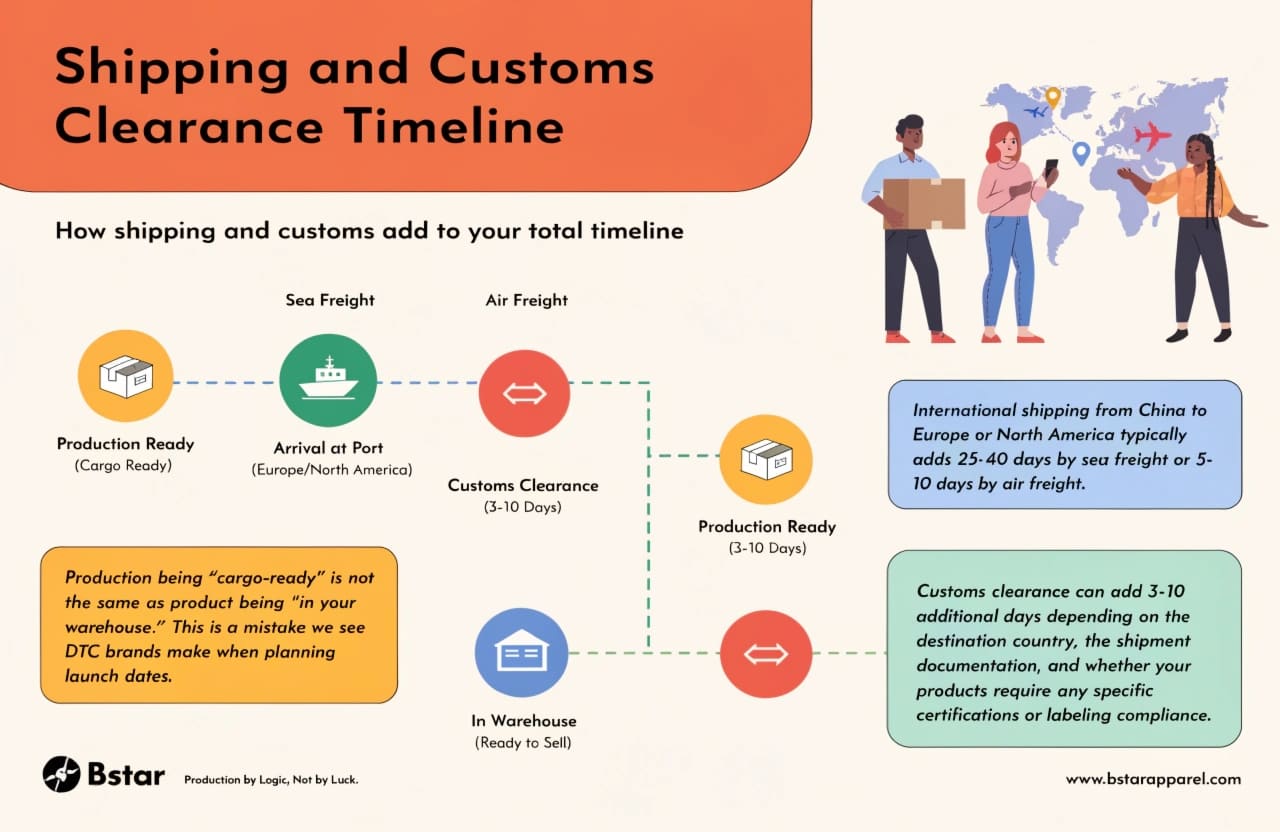

shipping and customs timeline for underwear imports

Planning Your Full Timeline Backward from Launch

The right way to plan is to start from your launch date and work backward9. Here is how a realistic DTC brand should think about it:

Phase Time Required
Bulk production (post-confirmation) 30–45 days
Sea freight (China to EU/US) 25–35 days
Customs clearance and local delivery 5–10 days
Buffer for delays 7–14 days
Total minimum planning window 67–104 days

If you need product in your warehouse by a specific date, count backward from that date using the table above. Then add your sampling and approval time before that. Most DTC brands need to place a confirmed order at least 3–4 months before a planned launch, especially for new styles.

Customs documentation matters more than many buyers expect. Underwear imported into the EU or US may need specific fiber content labeling, country-of-origin documentation, and compliance with chemical safety standards10. Our team helps prepare these documents, but buyers should confirm their local import requirements early. An incorrect label discovered at customs can hold an entire shipment11.



Conclusion

A bulk underwear order realistically takes 30–45 days in production, plus sourcing, approvals, shipping, and customs. Plan 3–4 months out from your launch date to stay safe.
