BSTAR / Manufacturing insights

Sample Development Timeline: From Tech Pack to Approved Prototype

Published Reading time9 min read
Fabric. Fit. Construction. Better-informed decisions.

Sample Development Timeline: From Tech Pack to Approved Prototype?

Getting an apparel sample made can look simple: send a tech pack, receive a prototype and approve it. In practice, the development timeline includes several separate stages, and the sewing of the sample is only one of them.

There is no universal number of days from tech pack submission to an approved prototype. The total timeline depends on specification readiness, material and trim availability, construction complexity, sample quantities, shipping, buyer review time and the number and scope of revisions.

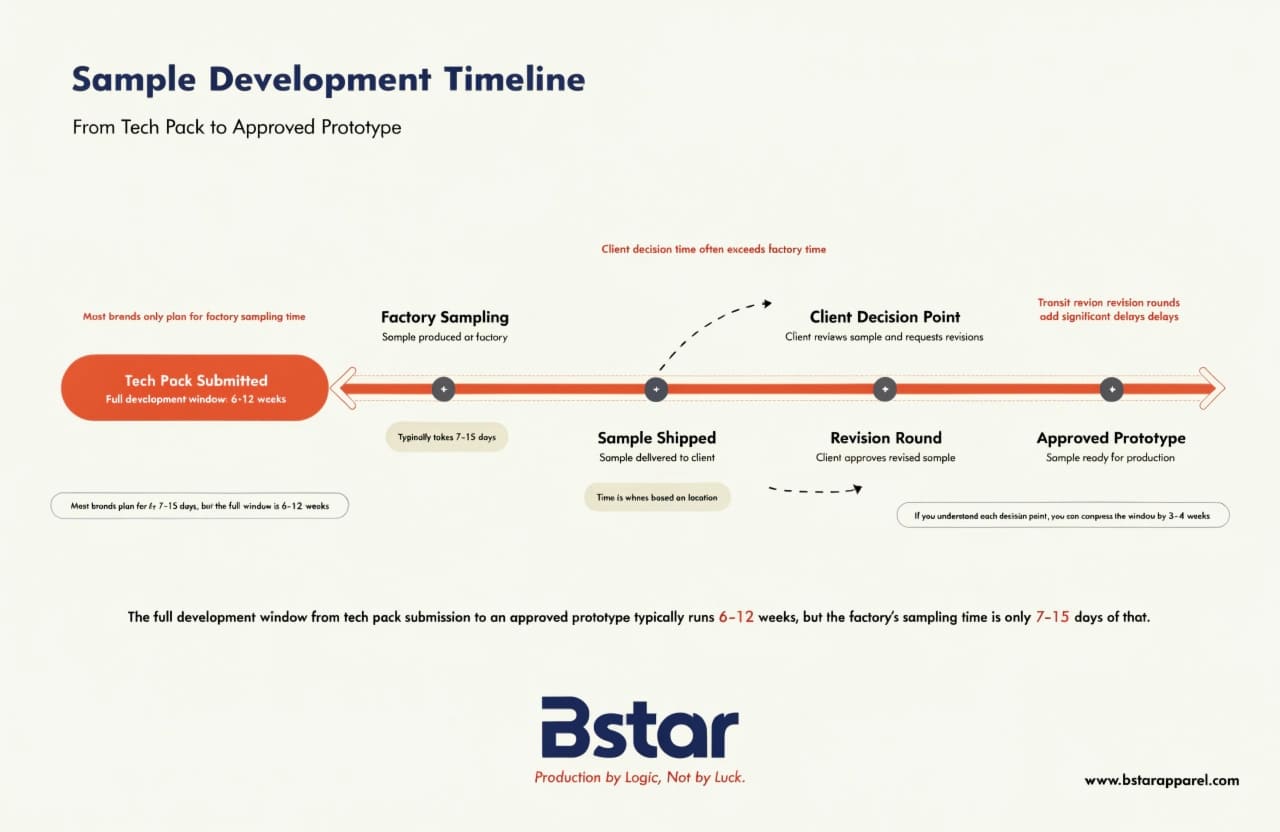

Sample development timeline from tech pack to approved prototype

A useful development schedule separates each stage instead of treating “sampling time” as one factory promise. The sequence normally includes tech pack review, material confirmation, sample planning, prototype making, transit, buyer evaluation, revisions and final approval. Each stage should have a clear starting point, responsible party and approval record.

To place this development sequence within the full path from product brief and fabric selection through MOQ, bulk production, quality control, packaging, and shipment, use the Men’s Underwear Manufacturing Guide.


Deconstructing the Tech Pack: Translating Design Concepts into Actionable Manufacturing Blueprints?

A polished document is not necessarily a production-ready tech pack. The key question is whether it gives the product development team enough information to understand what should be made and what still requires a decision.

Before sample making begins, the manufacturer and buyer need to identify missing or conflicting information. An unanswered question about materials, construction, measurements, colors or artwork can pause the schedule or create a sample that does not answer the intended development question.

Tech pack completeness review at knitwear factory

The following gaps commonly require clarification before the sample scope can be confirmed.

What Goes Wrong When Information Is Missing

Missing Element What the Development Team Needs to Do Possible Timeline Effect
Fabric composition, weight or stretch Clarify the target or propose a material for review Material review cannot be completed
Construction method or seam details Confirm how the garment should be assembled and finished Pattern or sample work may need to pause
Color reference or physical standard Agree how the color will be communicated and approved Material selection or color approval remains open
Measurement points and tolerances Confirm the base size, measurement method and acceptable variation Fit cannot be evaluated against a shared standard
Label, artwork or trim placement Request dimensions, artwork and positioning details Branding execution may require another review

A strong tech pack does not need unnecessary pages. It needs clear decisions. Product drawings, a measurement chart, material targets, construction notes, color references, artwork and packaging requirements should agree with one another.

If some details are intentionally open, mark them as decisions for development rather than allowing the factory to assume. A reference garment, sketch or early concept may still be a valid starting point, but any pattern, grading or technical-document work required should be identified in the agreed sample scope. The Sampling & Prototyping process explains how different starting points can be reviewed.


Sourcing and Lead Times: Navigating Fabric Procurement and Trim Availability for Prototypes?

After the initial specification review, material availability often determines when a meaningful prototype can begin. Fabric, elastic, labels, trims and packaging may come from different suppliers, each with its own availability and development requirements.

A sample can use final production materials or an agreed substitute, depending on its purpose. That choice must be recorded because a substitute used to review fit or construction does not approve the final color, hand feel, performance or production material.

Fabric sourcing and trim procurement for knitwear sampling

The sourcing route should be discussed before assigning a sample completion date.

Sourcing Scenarios and Their Impact on Sample Start Date

Scenario What Needs Confirmation Effect on Sample Planning
Available material option Composition, weight, stretch, color and suitability Sample making may proceed after the option is approved
Standard supplier material Current stock, replenishment and delivery arrangement Start date depends on supplier confirmation
Custom color or material Development work, minimum commitment and approval method Additional sourcing and approval stages may be required
Material with certification or traceability requirements Certificate holder, scope, validity, stock and order relevance Eligible supply and documentation must be checked before commitment
Buyer-supplied material Suitability, usable width, quantity, defects and transit The sample waits for receipt and inspection of the supplied material

Material decisions should be linked to the purpose of the sample. If the goal is to review shape and construction, an agreed substitute may be appropriate. If the goal is to approve color, hand feel or performance, the relevant final material may be necessary.

This distinction prevents an early prototype from being treated as approval for characteristics it was never designed to prove. It also allows sourcing, sample making and shipping to be planned as separate parts of the schedule. Material or component minimums should also be checked against the intended production plan; see MOQ & Order Planning for the related quantity decisions.


The First Sample Review: Evaluating Fit, Pattern Accuracy, and Construction Quality?

The first prototype translates a two-dimensional specification into a physical garment. Its purpose should be agreed before review. It may be intended to examine fit, measurements, construction, materials, branding details or a defined combination of these points.

A first prototype should be reviewed against the agreed brief rather than against an unrecorded expectation. The sample version, measurement method, material status and open differences should all be identified before feedback is issued.

First knitwear prototype review for fit and construction

Different review areas require different evidence and different decisions.

What to Evaluate on a First Proto (and How to Communicate It)

Review Area What to Look For How to Feed It Back
Fit and silhouette Shape, balance, comfort and movement on the agreed sample size Annotated photos and updated measurements
Pattern and measurements Panel shape, seam position and agreed measurement points Marked flat photos, measurement table and sample reference
Construction quality Stitching, joins, openings, finishing and relevant garment details Close-up images with specific written comments
Material and feel Composition status, weight, stretch, recovery and hand feel Approve, reject or request another option with a clear reason
Color and branding Color reference, artwork size, placement, labels and trims Compare with the agreed standard and record each decision

Feedback such as “the fit is wrong” does not identify an action. A useful comment names the sample version, location, current result, required change and supporting measurement or image. Buyers should consolidate internal comments before sending them so the factory is not working from conflicting instructions.

The buyer should also distinguish between items that are approved, items that require a change and items that need another check. Agreeing a review deadline helps the overall schedule, but the appropriate response period depends on the brand’s team, fitting arrangements and decision process. For men’s underwear, the product development guide shows review points such as waistband, pouch, seams and leg opening.


Iterative Feedback Loops: Streamlining Revisions to Achieve Final Production Approval?

The number of revision rounds cannot be assumed in advance. A well-defined product may require a focused change, while a new fit, new material or substantial specification change may require additional prototypes.

Each revision should begin with one confirmed feedback record and end with a clearly identified sample or decision. Changes to the original brief can affect materials, cost and timing, so their effect should be reviewed before the next round starts.

Iterative prototype revision cycles for OEM knitwear approval

Instead of promising a fixed number of weeks, build the timeline around the following sequence.

Realistic Timeline: Two-Round Development Scenario

Stage Starts When Ends When Main Schedule Dependency
Tech pack review and clarification Current files and references are received Missing information and sample purpose are identified Completeness of the brief and response to questions
Material and trim review Material targets are understood Final or substitute sample materials are agreed and available Supplier availability and approval requirements
First prototype making Sample scope, inputs and schedule are confirmed The identified first prototype is completed and dispatched Construction, sample quantity and factory schedule
Transit to buyer Shipment is released Buyer receives the sample Destination, carrier and customs conditions
First prototype review Buyer receives the correct sample and review information One consolidated feedback record is approved internally and sent Fit session, measurements and decision-makers
Revision review and making Factory receives confirmed comments Revised sample or focused check is completed and dispatched Scope of changes and any new materials
Final review Buyer receives the revision Approved reference and remaining differences are recorded Approval criteria and final decision authority
Production handover Sample approval is recorded Materials, quantities, price, timing and quality checkpoints are confirmed Final order terms and production readiness

This table is a planning sequence, not a fixed BSTAR or industry timeline. Every project should receive dates only after the specification, materials, sample quantities, revision scope and shipping arrangement have been reviewed.

Buyer response time is one part of the total elapsed time, but it is not the only variable. Supplier availability, material changes, revised artwork, fitting arrangements and factory scheduling can also move the next available sample slot. Both sides should record who owns the next action and what information is needed to start it.

Sample approval is not the same as automatic release for bulk production. The final specifications, material and trim choices, color and size quantities, packaging, applicable MOQ, price, production timing and inspection requirements still need to be confirmed before production begins.


Conclusion

The development timeline from tech pack to approved prototype is a chain of decisions rather than one universal lead-time number. A useful plan separates specification review, material sourcing, sample making, transit, buyer review, revisions and production handover.

Brands can reduce avoidable delays by defining what each sample should prove, confirming who has approval authority, sending consolidated evidence-based feedback and recording the approved reference. Manufacturers should identify open requirements instead of presenting an unreviewed schedule as a promise.


BSTAR’s own factory in Xiaolan, Zhongshan focuses on sewing, packing and shipment, while fabrics and trims are sourced through long-term suppliers. Sample scope, quantities, fees, timing and revision arrangements are confirmed after reviewing each project. Brands can share their sample requirements for a project-specific review.
