What Is the Average Lead Time for Underwear Production?

Most buyers ask for one number. “Just give me the lead time.” That is understandable when you have a launch date, a retailer delivery window, or inventory running low. The problem is that two suppliers can quote the same number while starting and stopping their clocks at completely different points.

There is no reliable industry-wide average that covers every underwear order. A useful schedule separates sample making, material preparation, buyer approvals, bulk production, final inspection, packing, and transport. For a typical cut-and-sew sample, once the key specifications and material plan are confirmed, BSTAR usually needs around 14 days to make the sample. Bulk production timing must be confirmed for the actual style, quantity, materials, colours, customisation, testing, packaging, and available production schedule.

Underwear production lead time breakdown chart

That distinction matters. Fourteen days for making a sample does not automatically include fabric development, unanswered specification questions, buyer review, revisions, performance testing, or international courier time. In the same way, a quoted bulk lead time may begin only after the approved sample, confirmed materials, purchase order, and agreed commercial release are in place.

Research on garment sample approval has also found that repeated submissions and slow approval exchanges can extend the pre-production calendar, although the exact result from one factory or market should not be treated as a universal benchmark.1 The practical lesson is simple: ask what each clock includes before you plan the launch.

What Does a Quoted 30 to 45-Day Production Cycle Actually Include?

You will often see “30–45 days” on sourcing pages and supplier profiles. Treat that as a starting point for a conversation, not as an industry standard. One supplier may mean sewing and packing after all materials arrive. Another may include fabric preparation. A third may be quoting a straightforward repeat order rather than a new custom style.

Before comparing two lead-time quotations, define the start event, the finish event, whether the count uses working or calendar days, and which approvals and materials must already be complete. Without those definitions, the numbers are not directly comparable.

Standard underwear production cycle phases

The quotation should also state whether it ends at finished packing, handover to the freight forwarder, shipment departure, or arrival at the buyer’s destination. International transport and customs clearance are separate planning blocks unless the supplier explicitly includes them.

The Three Production Phases You Need to Model

The original three-phase model is still useful, provided you do not force one fixed duration onto every order:

Phase What It Covers What Must Be Confirmed
Sampling and approval Pattern or specification review, prototype making, fit review, comments, and revisions Sample type, confirmed brief, available material plan, review time, revision scope, testing, and courier time
Fabric and materials preparation Fabric, elastic, labels, trims, packaging, colour approvals, and any required documents Stock status, supplier lead time, colour or print development, component compatibility, document holder, scope, and validity
Bulk production and release Order planning, material preparation, cutting and sewing as applicable, finishing, inspection, packing, and release Approved reference, purchase order, quantity and size breakdown, production booking, QC plan, packaging, and agreed handover point

These phases have dependencies, but they do not always run as three perfectly separate blocks. A factory may prepare selected materials while a final packaging detail is being confirmed, for example, if both parties accept the risk. It should not commit irreversible bulk work against an unapproved fit, colour, print, waistband, or care-label detail.

The sample development timeline guide explains how the approval sequence works in more detail. When requesting a quotation, ask the supplier to mark each phase as included, excluded, estimated, or pending confirmation.

To see where these timing blocks sit within the wider path from product brief through MOQ, bulk production, quality control, packaging, and shipping, use the Men’s Underwear Manufacturing Guide.

How Do Customization, Fabric Sourcing, and Order Volume Change the Timeline?

This is where buyers are most likely to compare unlike projects. A repeat order using an approved pattern, available fabric, and unchanged packaging is easier to schedule than a new pouch construction with a custom waistband, new colour, print strike-off, and market-specific labelling.

Customisation affects lead time because it adds decisions, supplier dependencies, setup, and approval points. Order quantity matters too, but quantity alone cannot predict the schedule. Style complexity, colour count, size mix, material availability, line loading, finishing, inspection, and packing can matter just as much.

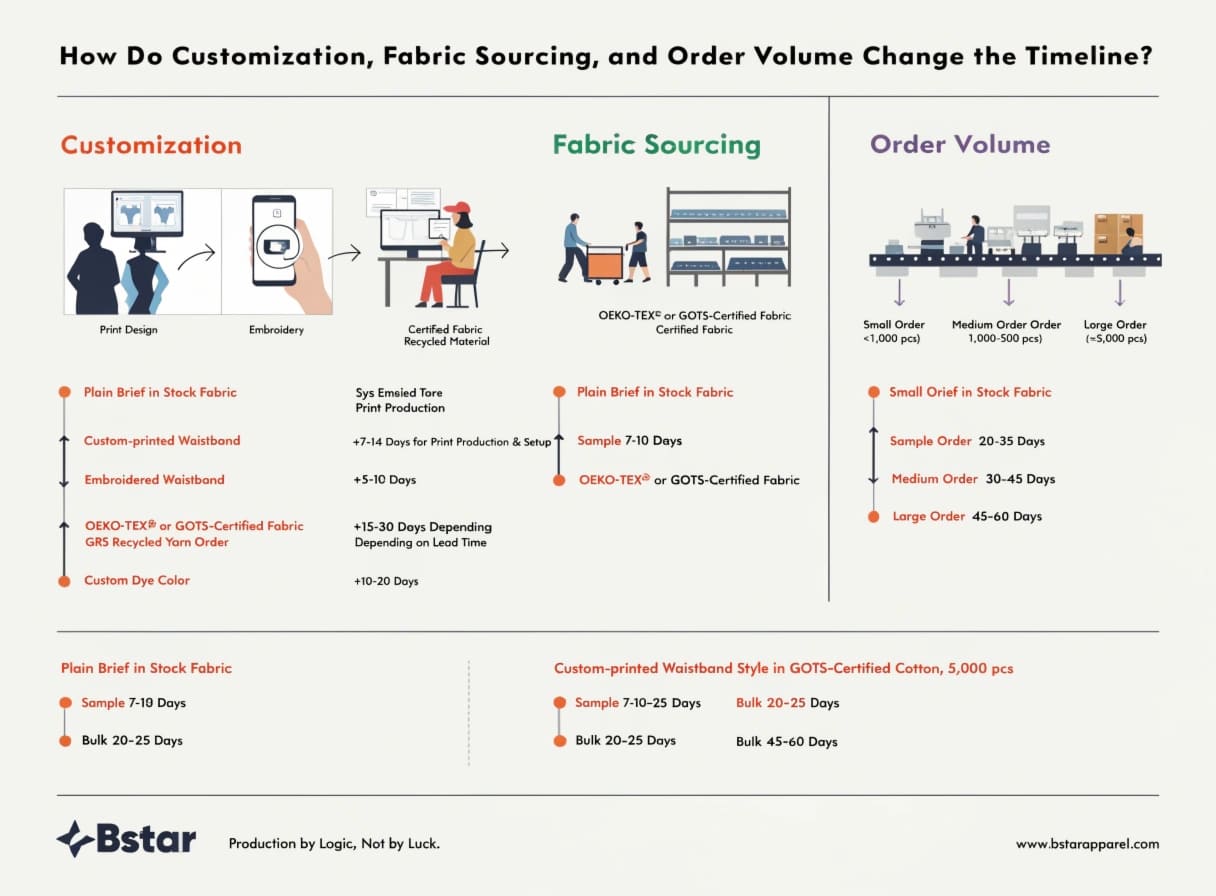

Variables that affect underwear production lead time

The best comparison is a style-specific schedule built from the same technical brief. If you are still defining the product, the men’s underwear product page shows the main style and customisation decisions that should be resolved before timing is confirmed.

Customization: The Silent Multiplier

Every custom feature should have an owner, an approval item, and a due date. Avoid adding a fixed number of days before the relevant supplier or process has been checked.

Customisation Requirement Why It Can Affect the Schedule What to Confirm Before Booking
Custom waistband, print, embroidery, or artwork Artwork review, colour matching, setup, strike-off or component sampling may be needed File format, colour standard, dimensions, placement, approval sample, and production supplier
New fabric, blend, weight, or colour Availability, knitting or dyeing, finishing, shade approval, and minimum supplier quantity may apply Exact composition, GSM target, colour reference, finish, test requirements, and supplier availability
Documented or certified material The required product, facility, input, and transaction documents may come from different organisations Certificate holder, certificate number, scope, validity, applicable product, and transaction documentation
New label or packaging system Legal copy, care instructions, barcode data, print proof, carton specification, and market language need approval Final copy, dimensions, material, artwork, proof, quantity, and destination-market requirements
Performance testing Testing begins only after the correct material or garment sample is available Test method, laboratory, specimen, conditioning, pass criteria, report owner, and retest procedure

Certification names are not interchangeable. OEKO-TEX® STANDARD 100 addresses textiles tested for harmful substances.2 GOTS applies to certified organic textile supply chains and processing requirements.3 GRS addresses recycled content, chain of custody, and additional processing requirements.4 FSC chain of custody relates to forest-based materials and their documented path through the supply chain.5

If one of these is required, do not simply write “certified fabric” in the brief. State exactly which document or claim the finished product needs. The OEKO-TEX® compliance checklist provides a practical way to review certificate scope before relying on it.

Order Volume: Bigger Orders Do Not Always Take Longer

A larger quantity usually requires more material, production time, inspection, and packing. It can also receive a dedicated production arrangement that makes its daily flow different from a small order. A small order with six colours, a custom waistband, and many size combinations may be harder to schedule than a larger repeat order with one approved specification.

For that reason, BSTAR does not use an unverified daily-capacity figure or a fixed quantity-to-days table as a promise. The order must be reviewed against the live production plan. Ask for these items in writing:

  • quantity by style, colour, and size;
  • material and trim availability;
  • approval status of every custom component;
  • planned production window and agreed start conditions;
  • inspection and packing requirements;
  • handover point and any excluded logistics time.

MOQ and timing should be reviewed together because supplier minimums, colour splits, packaging quantities, and order structure can change the material plan. The MOQ and order-planning page explains why a single universal MOQ or lead time is rarely useful.

How Do Sampling, Approvals, and Pre-Payment Work Together?

Sampling is often tracked separately from bulk production, but the exact commercial definition depends on the quotation. A buyer should never assume it is included. The same applies to material deposits, bulk payment conditions, and production booking: the applicable trigger is the one agreed in the quotation, proforma invoice, or contract.

At BSTAR, a typical cut-and-sew sample normally takes around 14 days to make after the key specifications and material plan are confirmed. Buyer review, revisions, new material sourcing, testing, and shipping are separate calendar items. If comments change the pattern, construction, fabric, waistband, artwork, or size specification, the next version needs a new timing review.

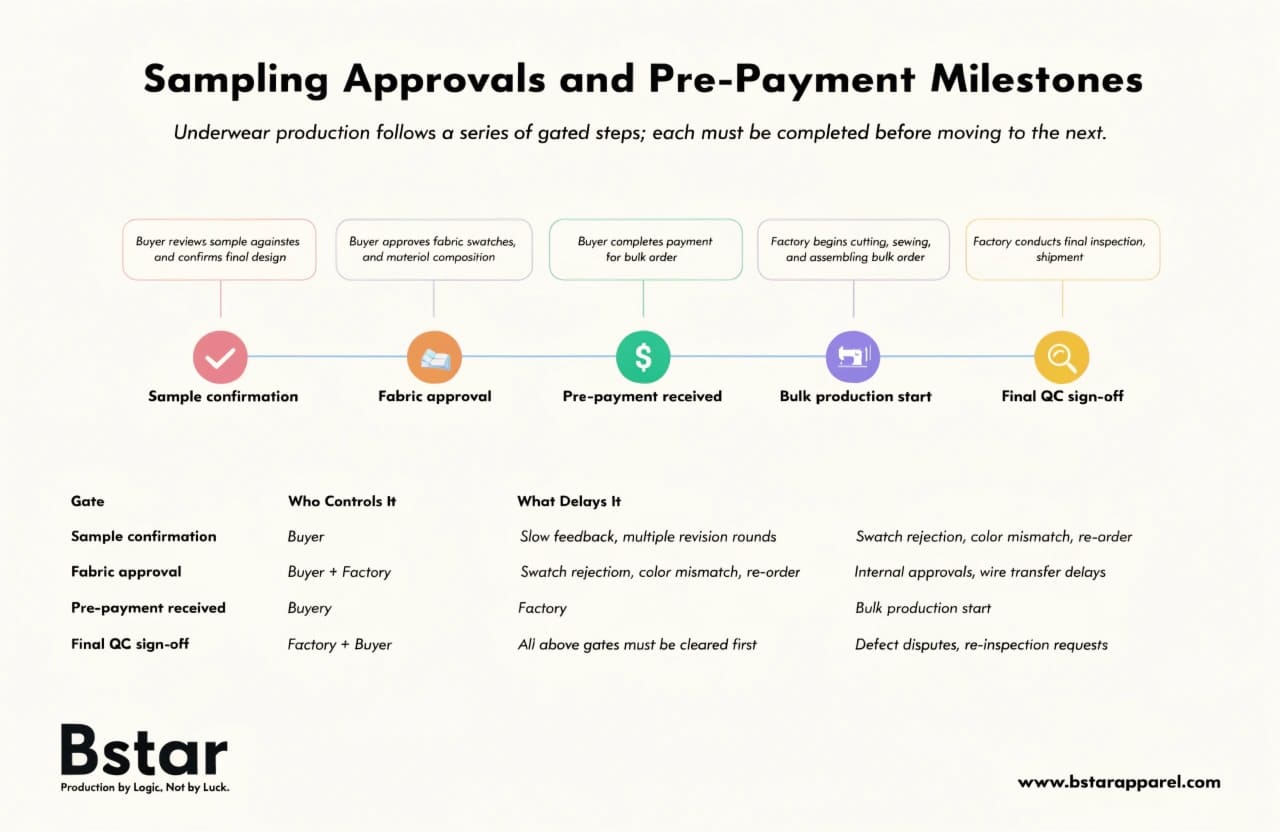

Sampling and approval milestones in underwear production

This is why a technically complete brief matters more than demanding the shortest headline number. The Sampling & Prototyping page lists the information needed to begin development.

The Gate Model: Why Your Timeline Stops and Starts

Think of the project as a series of decisions. Some work may overlap, but each irreversible step needs the right approval.

Gate Main Owner What Commonly Delays It
Development brief confirmed Buyer + Factory Missing measurements, unclear construction, incomplete artwork, or conflicting references
Sample ready for review Factory Unconfirmed materials, unavailable components, or unresolved technical questions
Sample and fit approved Buyer Slow feedback, comments from several decision-makers, or additional revision rounds
Materials and custom components approved Buyer + Factory Shade, print, waistband, label, packaging, test, or document questions
Commercial release completed Buyer + Factory Purchase order, quantity breakdown, payment condition, or production booking not agreed
Bulk order released Factory + Buyer as agreed Inspection findings, rework, document review, or buyer-designated inspection pending

Published apparel research supports the broader point that raw-material delays, repeated sample submissions, rework, and long approval periods can extend order execution.6 The exact number of days in a case study should not be copied into a different factory’s quotation, but the causes are useful when building a risk register.

Set one person on each side to consolidate comments. Put fit, construction, colour, artwork, labelling, packaging, and testing decisions into a single dated approval log. A fast reply helps only when it is also clear and final.

How Can You Speed Up Delivery or Handle Peak Season Crunches?

A rush request does not remove development, material, production, or quality requirements. It asks the supplier to find safe overlap, use confirmed resources, and reduce waiting between decisions. Whether that is possible depends on the actual order and the live schedule.

The most reliable ways to protect a launch date are to submit a complete brief, choose materials that can be confirmed early, reduce avoidable variation, return consolidated comments quickly, and reserve production only after the scope is stable.

Strategies for rush underwear orders and peak season

What You Can Control to Move Faster

Strategy Why It May Help Trade-Off or Condition
Submit a complete tech pack, artwork, size chart, and reference sample Reduces clarification loops and prevents different teams from working from different versions Requires more preparation before development starts
Use an available, already-reviewed material route Avoids a new fabric-development path Colour, hand feel, weight, finish, and documentation still need approval for the order
Consolidate sample comments Prevents conflicting instructions and repeated pattern changes Buyer stakeholders must agree before sending feedback
Freeze custom components before bulk release Allows the material and production plan to be built around approved inputs Late branding or packaging changes require schedule review
Agree the inspection plan early Makes the sample size, checkpoints, criteria, and release responsibility visible Additional testing or buyer-appointed inspection needs booking
Add schedule buffer before the market deadline Absorbs revision, supplier, transport, and customs variability Requires earlier internal decisions and inventory planning

There is no universal “peak season” calendar for every factory and market. Holiday programmes, regional holidays, material mills, logistics congestion, and existing bookings can create different pressure points. Ask for capacity and supplier availability when the order is ready for review, then work backwards from the required warehouse date.

Starting with one development sample may be possible for an agreed project, but it does not automatically reserve bulk capacity or guarantee the bulk MOQ. Sample quantity, sample charges, material availability, and production booking should be confirmed separately.

What You Cannot Rush

Colour development, printing, embroidery, waistband production, fabric finishing, curing where applicable, conditioning, laboratory testing, and corrective work all have process requirements. Removing a required step may move risk into the finished product rather than save useful time.

Quality inspection should also be defined instead of reduced to “AQL passed.” ISO 2859-1:2026 provides AQL-indexed sampling schemes for lot-by-lot inspection; the parties still need to agree the lot, inspection level, AQL, defect classifications, sample plan, and acceptance or rejection rules.7 A statistical final inspection does not replace in-process control or make every product in the lot defect-free.

Social-compliance monitoring is a separate subject. amfori describes BSCI as a member-based supply-chain due-diligence and monitoring system in which eligible members request audits for a specific producer site.8 An amfori BSCI audit document should not be presented as a product-quality certificate or as proof that an order passed six QC checkpoints.

When the launch date is fixed, send the complete style, quantity, materials, customisation, testing, packaging, destination, and required handover date through the contact page. A realistic schedule can then be built around the actual project rather than a generic internet average.

Conclusion

The useful answer to “What is the average lead time for underwear production?” is not one universal number. It is a schedule with clearly defined clocks.

For a typical cut-and-sew sample, BSTAR usually needs around 14 days to make the sample after the key specifications and material plan are confirmed. Material preparation, buyer review, revisions, testing, bulk production, inspection, packing, and transport must each be added or confirmed according to the project.

Before approving a launch calendar, ask the supplier to show the start condition, finish condition, inclusions, exclusions, dependencies, and approval owners for every phase. That is how a buyer turns a lead-time estimate into a production plan.

  1. Abuhay, G. et al., “Effects of Physical Sample Approval Practice on Performance and Competitiveness of Export-Oriented Garment Industries in Ethiopia,” Journal of Engineering (2020), https://doi.org/10.1155/2020/9760576. The study shows how sample approval exchanges can add time and cost in the factories examined; its measured durations are case-specific and are not used here as a BSTAR benchmark. ↩

  2. OEKO-TEX®, “STANDARD 100,” https://www.oeko-tex.com/en/our-standards/oeko-tex-standard-100/. STANDARD 100 is a label for textiles tested for harmful substances; the certificate holder, product scope, class, validity, and applicable components should be checked. ↩

  3. Global Organic Textile Standard, “GOTS Version 8.0,” https://global-standard.org/images/resource-library/documents/standard-and-manual/GOTS_v8.0_signed.pdf. GOTS requirements apply to defined certified goods, processing stages, operators, inputs, and claims; the word “organic” alone does not establish finished-product certification. ↩

  4. Textile Exchange, “Recycled Claim Standard and Global Recycled Standard,” https://textileexchange.org/recycled-claim-global-recycled-standard/. RCS and GRS cover third-party verification of recycled materials and chain of custody; GRS also includes additional processing requirements. ↩

  5. Forest Stewardship Council, “Chain of Custody Certification,” https://connect.fsc.org/certification/chain-custody-certification. FSC chain of custody tracks eligible forest-based material through the supply chain and does not function as a general certification for every textile component. ↩

  6. Abir, S. A., “Study on Factors Delaying Lead Time in the Apparel Supply Chain Management,” European Scientific Journal 16(3), 244 (2020), https://doi.org/10.19044/esj.2020.v16n3p244. This case study identifies approvals, rework, misunderstanding, capacity, and raw-material supply among lead-time risks; its numerical findings apply to the studied order rather than all apparel production. ↩

  7. ISO, “ISO 2859-1:2026 — Sampling procedures for inspection by attributes,” https://www.iso.org/standard/2859-1. The standard defines AQL-indexed acceptance-sampling schemes for lot-by-lot inspection and was published in January 2026. ↩

  8. amfori, “How to request an audit as a producer,” https://support.amfori.org/en/support/solutions/articles/24000079551-how-to-request-an-audit-as-a-producer. amfori explains that BSCI audits are requested within its member-based system by the responsible member for the producer site. ↩
